Quality Assurance & Regulatory Specialist
✓ Reviewed by: Pankaj Sharma - Quality Control Specialist
Reviewed for Quality Control accuracy, laboratory practices, analytical methods, and technical relevance
📅 Last Updated: October 28, 2026
Media fill interventions are the manual actions operators perform during an aseptic process simulation (APS), also known as media fill. As per EU GMP Annex 1 (9.34), it asks you to include inherent and corrective interventions in a manner and frequency similar to routine production. Inclusion and frequency should rest on the assessed risk to product sterility. Worst-case conditions must cover the relevant variables, such as container size and line speed, and the assessment must justify the variables you select (9.36). Record every intervention with its start time, end time and the person involved (9.47).

What Are Media Fill Interventions in an aseptic process simulation?
A media fill intervention is any action that disturbs the undisturbed flow of aseptic work while sterile nutrient media stands in for the product. Operators clear a jam, refill a stopper bowl or change a part. If anything contaminates the open units, the media turns turbid during incubation.
For the full overview, see What is Media fill in Pharmaceutical. This article stays on one question: which interventions go into the run, how often, for how long, by whom, and how you defend those choices.
Annex 1 calls the APS a periodic verification of the controls in place, not the primary means to validate the aseptic process (9.32). Process design, training and monitoring data carry that weight. The aseptic process simulation shows whether those controls hold when people actually work at the line. If you need the basics first, read Aseptic and Sterile in Pharmaceutical and the SOP on aseptic handling, operation and aseptic connection.
What Is the Difference Between Inherent and Corrective Interventions?

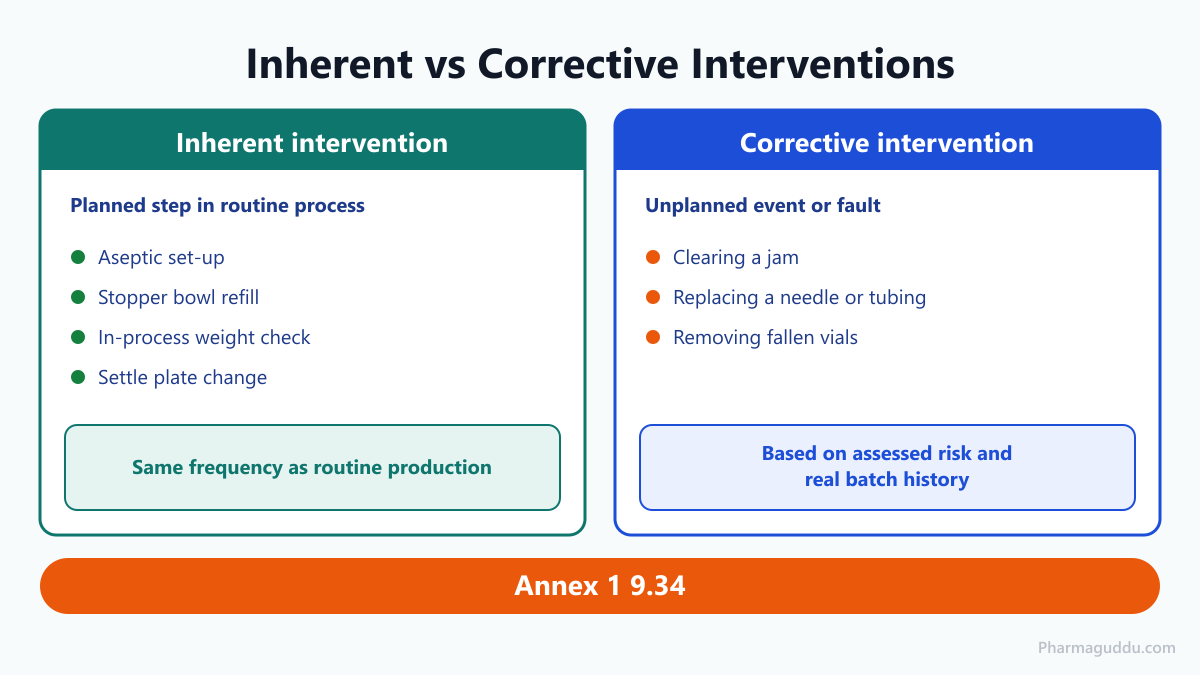

Annex 1 9.34 uses two terms. Inherent interventions belong to the routine process and happen every batch. Corrective interventions fix an unplanned problem on the line. Annex 1 gives no definitions or examples, so the examples below are typical industry practice. They are not universal: ISPE lists removing jammed stoppers or toppled vials as routine interventions, so each site should classify them from its own process history and risk assessment.
| Feature | Inherent intervention | Corrective intervention |
|---|---|---|
| Trigger | Planned step in the routine process | Unplanned event or fault |
| Typical examples | Aseptic set-up, stopper bowl refill, in-process weight check, settle plate change | Clearing a jam, replacing a needle or tubing, removing fallen vials |
| How often in the APS | Same frequency as routine production | Based on assessed risk and real batch history |
| Main risk | Repeated exposure | Unusual, longer, closer to open product |

Both types must be representative of the routine process and performed the way operators perform them in production (9.34 i). Annex 1 also says an APS should not be used to justify practices that pose unnecessary contamination risks (9.35). If a corrective intervention forces an operator to reach over open vials, fix the technique or the equipment. Don’t qualify it.
How Do You Justify Worst-Case Conditions Through Risk Assessment?
Annex 1 9.36 i asks you to identify worst-case conditions covering the relevant variables, such as container size and line speed. The outcome of the assessment should justify the variables selected. Worst case here is a documented choice, not a feeling. Anyone reading the protocol should see why each variable was picked and why others were left out.
Section 9.36 names the variables to consider:
- Representative container and closure sizes. A bracketing or matrix approach may be considered where process equivalence is scientifically justified (9.36 ii).
- Maximum permitted holding times for sterile product and exposed equipment (9.36 iii).
- Fill volume that lets the media touch all surfaces that could contaminate the product (9.36 iv).
- Normal interruptions while the process is idle, such as shift changeovers, recharging dispensing vessels and bringing in extra equipment (9.36 x).
- Factors tied to different or extended shifts, for example the longest time an operator may stay in the cleanroom (9.36 ix).
- The start and end of a campaign, where campaign manufacturing applies (9.36 xii).
For lyophilised products, 9.33 vi adds that the simulation should cover filling, transport, loading, a representative chamber dwell, unloading and sealing under documented worst-case operating parameters. For sterile powders, 9.33 iv asks for an acceptable surrogate in the same containers. This matters on a line such as the one described in the SOP on sterilized powder filling machine.
A practical way to build the justification, based on common industry practice rather than a fixed Annex 1 method:
- Collect every intervention seen in batch records, deviation reports and line observation or video.
- Rank each by risk: closeness to open product, duration, operator skill needed and how often it happens.
- Set the APS frequency from real routine data, as 9.34 requires.
- Add rare, higher-risk corrective interventions to the run as the risk assessment dictates.
- Write down every intervention you leave out, with the reason.
- Send the final list to QA for approval under change control.
On the shop floor, the intervention nobody writes down is usually the one that later causes the problem. A catalogue built only from the SOP misses it.
How Often and How Long Should Interventions Be Simulated?
Frequency follows the routine process and the risk assessment (9.34). Duration needs the same honesty. If a corrective intervention takes two minutes in production, don’t simulate it in twenty seconds.
The whole run must also be long enough to challenge the process, the operators doing interventions, shift changes and the capability of the environment (9.36 viii). The table summarises the Annex 1 numbers.
| Parameter | Annex 1 expectation | Clause |
|---|---|---|
| Initial validation | At least 3 consecutive satisfactory aseptic process simulation covering all working shifts | 9.38 |
| Periodic revalidation | Normally twice a year (approximately every six months) per aseptic process, filling line and shift | 9.38 |
| Operator participation | Each operator in at least one successful aseptic process simulation annually | 9.38 |
| Manual operations | Each operator in at least 3 consecutive successful APS initially, then about every 6 months | 9.39 |
| Run size | Typically a minimum of 5,000 to 10,000 units; small batches at least equal the production batch | 9.40 |
| Target | Zero growth; any contaminated unit fails the APS | 9.46 |
| Incubation | Conditions and duration scientifically justified and validated; no fixed values | 9.44 |
Section 9.40 also says the number of units must be justified in the contamination control strategy (CCS), the site’s documented plan for controlling contamination risk.
Who Takes Part in the Interventions?
Personnel are part of the test. Each operator joins at least one successful aseptic process simulation every year (9.38). Where work is manual, such as aseptic compounding or filling, each operator completes at least 3 consecutive successful APS for each container type, closure and equipment train. After that, they repeat about every 6 months (9.39).
Plan the roster so operators perform the interventions they perform in production. An APS staffed only by your most experienced people tells you little about the night shift.
After critical interventions, monitor gloves, and gowns where the process needs it. Replace the outer gloves or the gown before work continues (9.25). Do the same in the APS as in routine production. If the root cause of a failure points to an operator’s activity, restrict that person’s work until retraining and requalification (9.46 vi).
How Do You Record Interventions and Handle Units?
Section 9.47 requires the APS to be fully documented. The record includes a reconciliation of units filled, incubated and not incubated, with a justification for any filled unit that is not incubated. Every intervention is recorded with its start time, end time and the person involved. Microbial monitoring and other test data go into the APS batch record. Environmental monitoring runs as in routine production for the whole simulation (9.36 xi). Your AHU performance qualification data supports the cleanroom side of that picture.
Unit handling needs discipline:
- Agitate, swirl or invert filled units before incubation, and incubate every integral unit, including those with cosmetic defects (9.41).
- Discard units only where production SOPs require the same removal under the same circumstances. Never remove more units than a production run would clear (9.41).
- Simulate discarded material such as product flushes with media and incubate it, unless you can show the waste process cannot affect sterility (9.42).
- Abort an APS run only where written procedures treat commercial lots the same way, and document an investigation (9.48).
What Does QC Control Before and After the Run?
The QC analyst qualifies the media for growth promotion with the reference organisms named in the pharmacopoeia and suitably representative local isolates (9.36 vi). The fill volume must leave enough headspace for growth and for turbidity to be seen (9.36 iv).
After incubation, trained and qualified personnel inspect the units under suitable conditions. Samples also receive a positive control, inoculated with reference organisms and local isolates (9.45). Incubate in clear containers, or use a validated detection method where clear ones cannot be substituted. Identify organisms from contaminated units to species level where practical, to trace the source (9.43).
What Do the Regulations Say?
Annex 1 was published on 25 August 2022 and came into operation on 25 August 2023, except point 8.123, which followed on 25 August 2024. Its revision was jointly recommended by the GMP/GDP Inspectors Working Group and the PIC/S Committee. Section 9.32 to 9.49 is the backbone for everything above. In the United States, FDA’s 2004 guidance, Sterile Drug Products Produced by Aseptic Processing, is the matching reference for media fill expectations.
Recent Technology Trends
- Annex 1 in operation (2023 to 2024). All APS clauses discussed here, including the intervention recording rule in 9.47, now apply across the EU.
- PDA Technical Report No. 22 revised (October 2025). PDA’s bookstore lists a revised process simulation report that reflects Annex 1 and a CCS view of APS.
- Intervention data analysis (A3P, January 2025). An A3P article argues for intervention frequencies drawn from real manufacturing data and for statistical alert limits with trend analysis. This is one author’s proposal, not a requirement.
- AI vision monitoring (ISPE, May 2023). A case study describes machine-learning detection of operator intrusions into the critical zone. The authors suggest continuous monitoring might reduce reliance on media fills. Annex 1 still expects periodic APS (9.32, 9.38) and a record of every APS intervention (9.47).
Common Problems and Troubleshooting

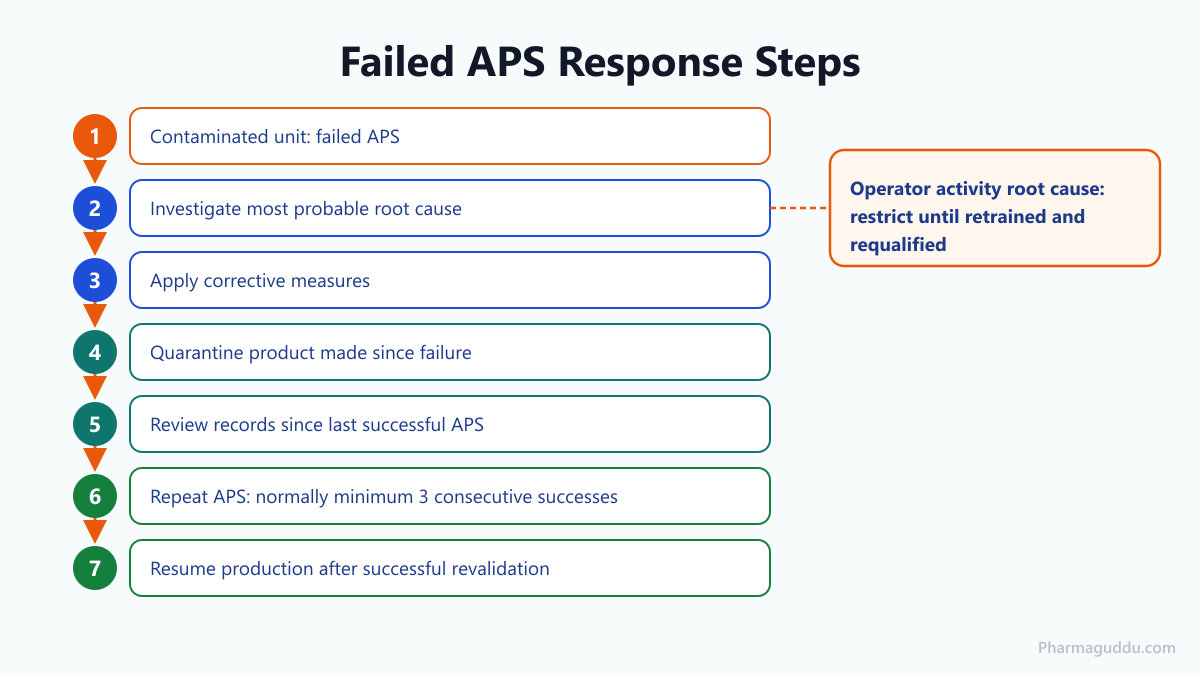

A contaminated unit means a failed APS. Annex 1 9.46 sets out the response, shown below.

The QA manager opens a deviation. The team finds the most probable root cause, applies corrective measures, then runs a sufficient number of consecutive successful repeat APS, normally a minimum of 3. Records since the last successful APS are reviewed, with a risk assessment of possible sterile breaches. Product made on the line after the failure stays in quarantine, and production resumes only after successful revalidation. Add a CAPA effectiveness check so the same cause doesn’t return.
Intervention list copied from an old protocol
Possible Causes: no review after a line change, new container or new equipment.
Corrective Actions: rebuild the catalogue from current batch records, and send changes through change control. Annex 1 9.49 requires a repeat of the initial validation after a change that could affect the process, or a new container or closure combination.
Units removed that production would not remove
Possible Causes: operators clearing extra vials during an intervention to stay safe.
Corrective Actions: match removal to the production SOP and justify the numbers (9.41). Incubate set-up units separately where needed.
Incomplete intervention records
Possible Causes: no one assigned to time and log interventions during the run.
Corrective Actions: assign a recorder, such as a QA officer, and log start time, end time and person for each intervention (9.47).
Expert Tips
- Build the list from evidence. Use batch records, deviations and observation, not the SOP alone.
- Time real interventions. Use measured durations from production, not convenient ones.
- Name the person. Record who performed each intervention, because 9.47 asks for it.
- Justify exclusions in writing. A missing intervention with no reason invites questions.
- Rotate roles. Let each operator perform the interventions they do in routine work.
- Tie the list to change control. Any new routine intervention triggers a review of the APS plan.
- Keep set-up units visible. Incubate them separately so they give learning without distorting acceptance.
Frequently Asked Questions
Build an intervention catalogue from batch records, deviations and observation, rank each one by risk, and set frequency from real data. Annex 1 9.34 says inclusion and frequency should rest on assessed risks to product sterility. Document the reason for every intervention you exclude, and have QA approve the list.
Section 9.36 i asks for worst-case conditions covering the relevant variables, such as container size and line speed. It says the outcome of the assessment should justify the variables selected. Related points cover holding times, extended shifts, idle interruptions and campaign start and end.
Initial validation needs at least three consecutive satisfactory aseptic process simulation covering all shifts. After that, periodic revalidation is normally twice a year (approximately every six months) for each aseptic process, filling line and shift (9.38). Each operator takes part in at least one successful APS annually.
Yes, where they occur in routine work. Annex 1 9.36 viii says the simulation should be long enough to challenge shift changes. Clause 9.36 x asks you to simulate normal idle interruptions such as shift changeovers. Different or extended shifts need their own risk factors considered (9.36 ix).
The aseptic process simulation fails. You investigate the root cause, apply corrective measures, quarantine product made on the line since the failure, and review records since the last successful APS. Production resumes only after successful revalidation, which normally means at least three consecutive successful repeat APS (9.46).
Only if the production SOP requires the same removal in the same circumstances. Never remove more units in a media fill intervention than a production run would clear (9.41). Discarded units must be comparable with routine practice, and you must justify any filled unit that is not incubated (9.47).
